The Real Clock · Quebec

Wasamac gold

Review ended without a decision

Checked: · This is a dated check, not a live feed.

Days on the calendar

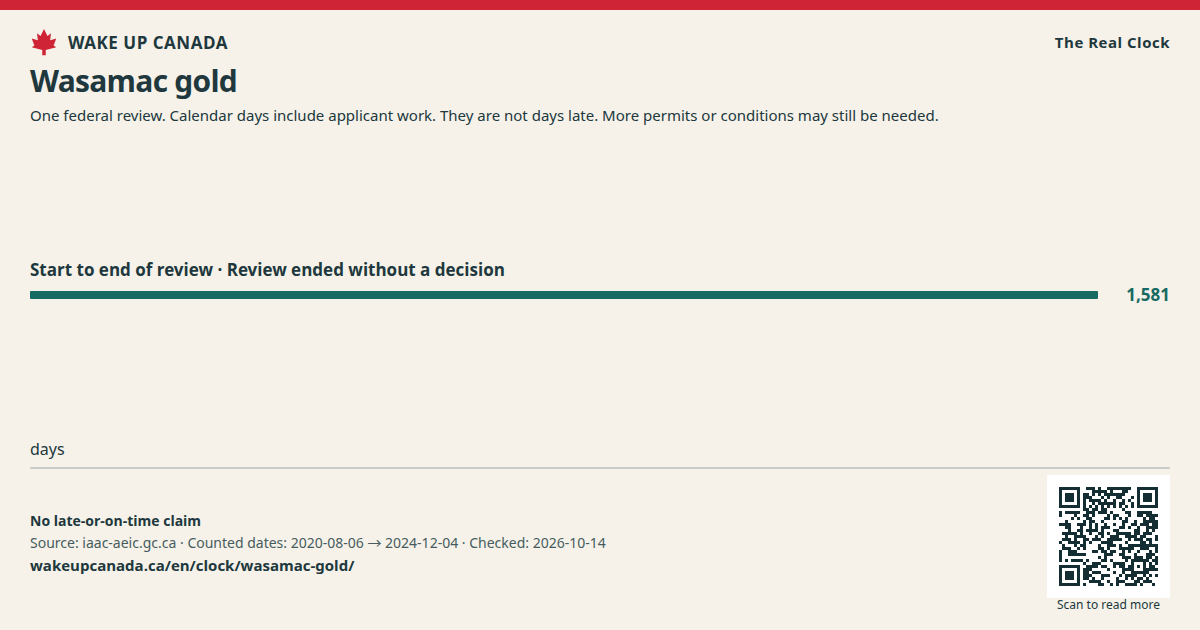

1,581days

Start to end of review

Record start
Count ends
Share image Wasamac gold

WAKE UP CANADA

Share the case for change

Wasamac gold

Keep the source, date and notes with the image.

Checked:

wakeupcanada.ca/en/clock/wasamac-gold/
Scan to open this page
Scan this code to read the full case.

Save an image

If the image opens in a new tab, press and hold it or use your browser’s save tool.

The clocks on the public record

These are the days counted for each phase by the agency when we checked. They are not one clock. We have not checked every pause or legal change.

Government-led phase

Plan the review

Complete

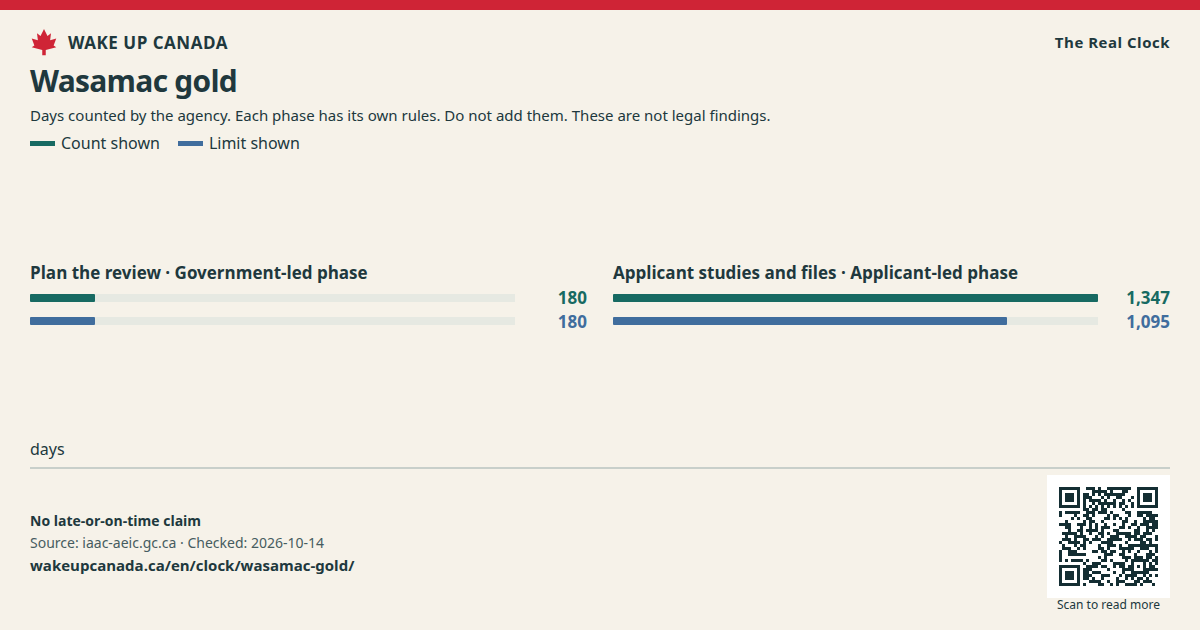

Count shown
180 days
Limit shown
180 days
Source ↗

Applicant-led phase

Applicant studies and files

Ended

Count shown
1,347 days
Limit shown
1,095 days
Source ↗

Do not add the day counts from these phases. Their rules and start points differ. No late-or-on-time claim.

Share image The clocks on the public record

WAKE UP CANADA

Share the case for change

The clocks on the public record

Keep the source, date and notes with the image.

Checked:

wakeupcanada.ca/en/clock/wasamac-gold/
Scan to open this page
Scan this code to read the full case.

Save an image

If the image opens in a new tab, press and hold it or use your browser’s save tool.

What happened

  1. Before our count starts

    First project summary filed

    Source 1 ↗

  2. Start date on the registry

    Source 1 ↗

  3. Decision that a review is needed

    Source 1 ↗

  4. Notice to start the assessment

    Source 1 ↗

  5. Review ended: applicant did not give the required files in time

    Source 1 ↗

Read this with the numbers

A decision ends this first review clock. More permits or conditions may still be needed. Listing a project does not mean we support it.

The Real Clock

What we want

Make every stage clear. Say who must act next. Explain each pause. Keep strong rules for harm and rights.

Read our case for a clear clock ↗
  1. Publish one clear record for each project.
  2. Show who must act next and by when.
  3. List each pause, its reason and who asked for it.
  4. Publish decisions and reasons on time. Keep public input and Indigenous rights.

How we count

We do not apply one two-year promise to all these projects. Listing a project does not mean we support it.

Sources

  1. Wasamac Gold Mine Project — Canadian Impact Assessment Registry ↗Source document in English
  2. Impact Assessment Act ↗Source document in English
  3. Information and Management of Time Limits Regulations ↗Source document in English
